- Supply and install 2x 604kW free-cooling Airedale chillers
- Factory witness test of chillers & RACU’s

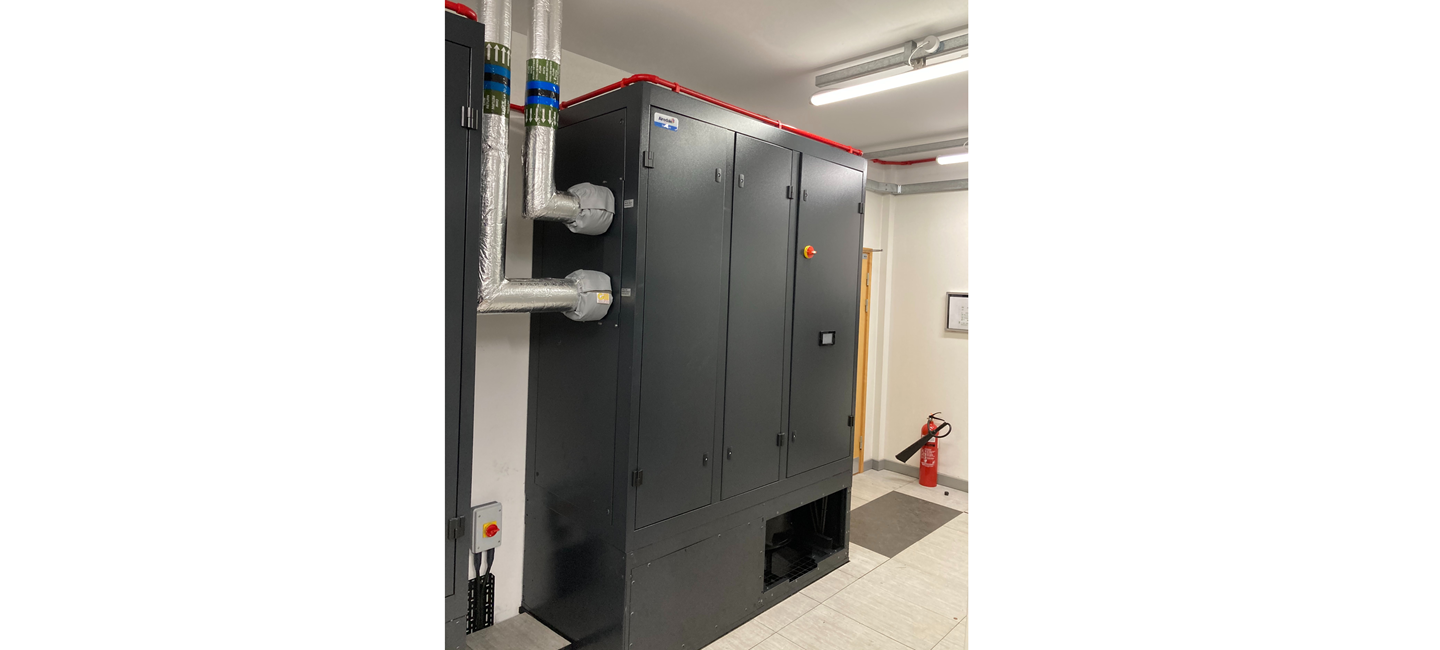

- Provision of 11x Airedale 60kW downflow cooling units (5x in Comms Room & 6x in Switch 5) complete with floor stand supports
- Provision of new stainless chilled water pipework ring main from external chiller compound into roof void and down to individual RACU units in the switch rooms
- Installation of new external pressurisation unit in GRP housing
- Phased de-gassing of redundant DX cooling units and removal from site
- Remove redundant DX condensers from external plant compound
- Strip out redundant DX refrigeration pipework and associated containment.
- Provision of new mains cold water supply to chilled water pressurisation unit

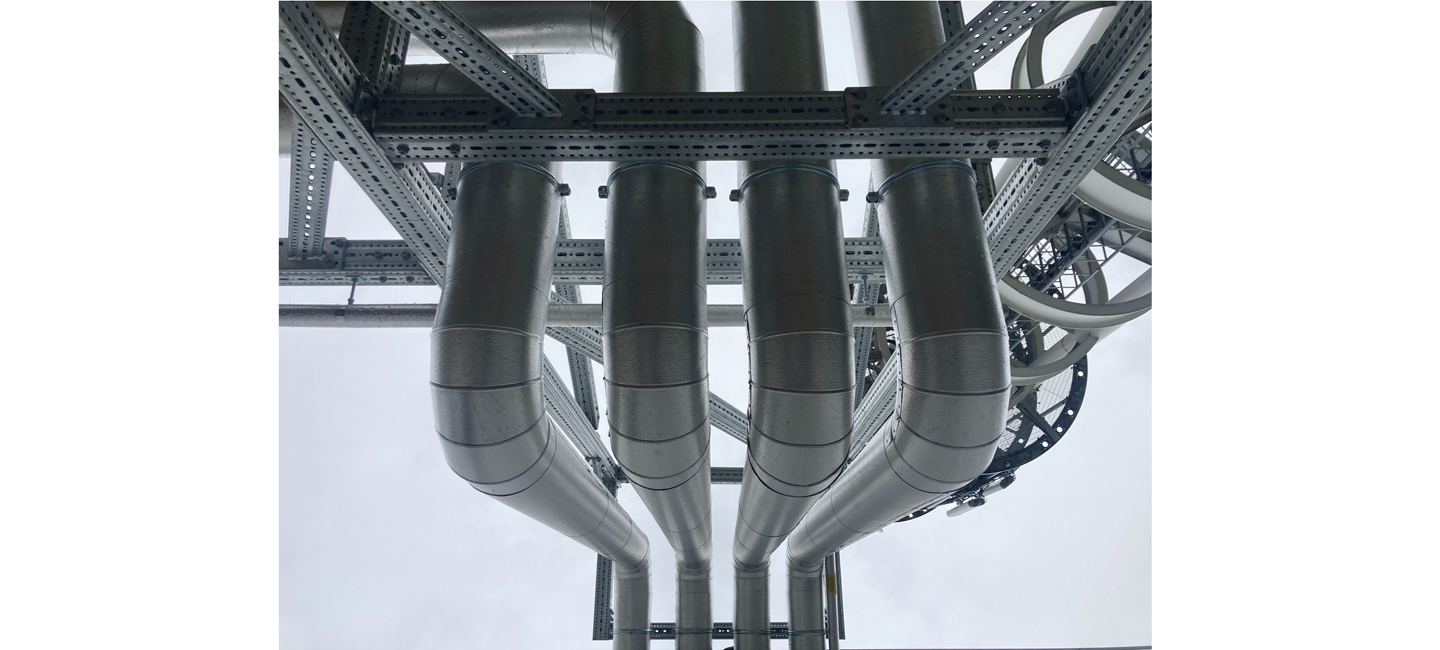

- Thermal insulation to chilled water & mains water pipework
- Trace heating to mains cold water service pipework
- Provision of drip trays c/w leak detection system under chilled water ring main in roof void
- Make good holes through ceiling from redundant pipework drops
- Modify existing condensate pipework to suit new cooling units
- Provision of new floor grilles c/w dampers
- Associated BMS upgrade works to interface with new cooling units

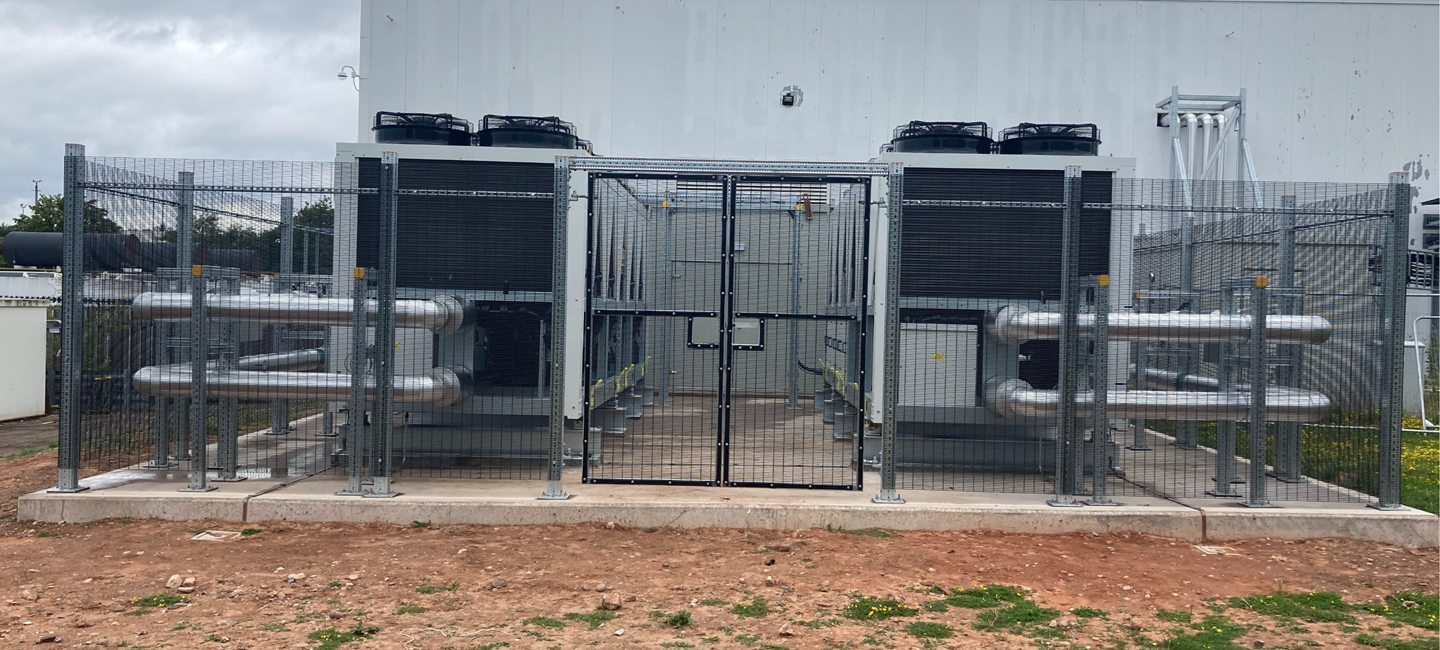

- Provision of new external concrete base for 2x chillers including mesh fence around compound
- Flushing & cleaning of new chilled water pipework prior to filling new pipework with glycol/water mix.
- Load test new chillers utilising temporary boiler plant.
- Heat load test in switch 5 & comms room
- Balancing of chilled water pipework to each cooling unit
- Builderswork holes for cabling & containment including firestopping
- Decoration to walls in affected areas
- Testing & commissioning including balancing of floor grilles
